Leading manufacturer and supplier of ready mix concrete, liquid screed and concrete pumps for the South West
  • Variety of dimensions available
  • Manufactured on site
  • Available for delivery or collection
  • Request a quote

Concrete Block Manufacturers

Wright Readymix is one of the leading concrete block manufacturers in the South West, manufacturing dense concrete blocks at its own plant in Avonmouth and supplying them directly to builders and contractors across Bristol, Bath, Newport, Cardiff, and the wider South West and South Wales.

As the manufacturer and supplier, we control the process from mix design through to despatch, because buying direct means there is no intermediary between your order and our production line. Concrete blocks are available in a full range of sizes for cavity and solid wall construction, for delivery or collection from our Avonmouth plant.

Dense Concrete Blocks: What We Manufacture



Dense concrete blocks are manufactured with a dense aggregate mix, resulting in higher compressive strength and mass than lightweight or aerated alternatives. This makes them the specified choice wherever structural performance, sound insulation, or fire resistance is a requirement, including load-bearing walls, party walls, and below-ground masonry.

Our dense concrete blocks are manufactured to a compressive strength of 3.6–30 N/mm² and a shear bond strength of 0.15N/mm² (tabulated value), with a D1 dimensional tolerance. They meet BS EN 771-3 for aggregate concrete masonry units and are tested to the A1 fire resistance grade, making them suitable for Approved Document B applications without additional treatment.

For full dimensions and technical specifications, see our concrete blocks page.

concrete block manufacturer

concrete block supplier

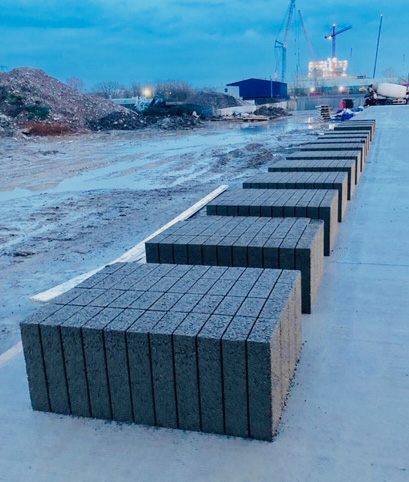

Block Sizes Available



At Wright Readymix, we manufacture concrete blocks in a range of dimensions to match project requirements:

  • Lengths: 290mm, 390mm and 440mm, sized to reduce cutting and speed up laying across most standard wall runs.
  • Widths: 75mm, 100mm, 140mm, 190mm, 215mm, 300mm and 440mm, covering cavity, solid, and party wall construction.
  • Heights: 100mm, 140mm, 190mm and 215mm, matched to standard coursing heights.

As with the dimensions, our concrete blocks page provides full technical specifications.

Why Choose a Local Concrete Block Manufacturer?



Ordering from one of the region's established concrete block manufacturers, rather than from a distributor, changes what happens on site. Lead times are shorter, deliveries are easier to schedule around your programme, and if you have a question about specification, you're speaking to the team that makes the product.

Wright Readymix manufactures dense concrete blocks at its own plant in Avonmouth, overseeing every stage from mix design and batching through to despatch. There is no third-party intermediary, no uncertainty over stock availability, and no passing the question on to someone else. When you order from us, you're dealing directly with the concrete block manufacturer.

For larger or more complex projects, Wright Readymix is backed by the LGW Group, which provides additional capacity and extended supply support without adding a layer between you and the plant.

Local manufacture also reduces haulage distances. Blocks despatched from Avonmouth reach sites across Bristol, Bath, and the wider South West faster than material trucked in from national distributors further afield.

Concrete Block Suppliers Across the South West & Wales



We are among the region's most established concrete block suppliers, serving construction projects across Bristol, Bath, Newport, Cardiff, Weston-super-Mare, Taunton, Cheddar, and Paignton, as well as the wider South West and South Wales.

Five manufacturing plants support this coverage, keeping delivery routes short and lead times consistent across the region. As concrete block suppliers with our own manufacturing base, we supply blocks in packs of 88, palletised and ready to offload, with delivery arranged direct to site or collection available from our Avonmouth plant for customers who prefer to arrange their own transport.

Get in touch with one of the top concrete block suppliers today to confirm availability and delivery to your site.

Applications for Dense Concrete Blocks



Dense concrete blocks are specified across a wide range of construction projects, from single-storey extensions to larger commercial developments.

Common applications include strip and trench fill foundation walling, load-bearing internal and external walls, and cavity wall construction where strength and moisture resistance are required. Their fire resistance and sound insulation properties also make them suited to party walls and compartment walls in residential and commercial developments, as well as retaining walls and below-ground masonry.

Builders and developers specify our dense concrete blocks for both new-build housing and renovation work, where consistent strength and dimensional accuracy keep build programmes on schedule. Dense concrete blocks are also used in garages, sheds, and garden walls, where their resistance to moisture and impact is well-suited to close-built developments.

If you're unsure whether a dense or lightweight block is the right specification for your project, our team can confirm the right type and size before you order.

Get in Touch



Wright Readymix is here to help with concrete block orders of any size, from a single pallet to a full site delivery. Call our team on 0117 958 2090 or request a quote online, and we'll confirm sizes, availability, and delivery to your site.

Concrete Block Manufacturers FAQs



We manufacture dense concrete blocks in a range of lengths (290mm, 390mm, and 440mm), widths (75mm, 100mm, 140mm, 190mm, 215mm, 300mm, and 440mm), and heights (100mm, 140mm, 190mm, and 215mm). If you need a specific combination for your project, contact our team and we will confirm availability.

We offer both. Blocks are delivered in packs of 88 directly to site or to your yard, and we will arrange a delivery slot that works with your build programme. If you prefer to collect, our Avonmouth manufacturing plant is open for customer collections – call the team to arrange.

Both. Wright Readymix manufactures dense concrete blocks at our own plant in Avonmouth, which means we supply direct from production. You are not ordering from a distributor or middleman – you are ordering from the manufacturer.

We deliver across Bristol, Bath, Newport, Weston-super-Mare, Taunton, Cheddar, Paignton, and the surrounding South West and South Wales region. To confirm delivery to your location, call us on 0117 958 2090 or use the contact form to request a quote.

Dense aggregate blocks are manufactured with a higher-density aggregate mix, resulting in greater compressive strength and mass than lightweight or aerated alternatives. This makes them the specified choice for load-bearing walls, structural applications, sound insulation, and fire-resistant construction.

Lightweight blocks trade some of that strength for better thermal performance, making them more suited to non-structural or insulation-focused applications. Wright Readymix manufactures and supplies dense aggregate blocks, tested to BS EN 771-3 and to A1 fire-resistance grade.

Concrete blocks are supplied in packs of 88, which is the standard unit we work to across deliveries and collections. Whether a smaller quantity can be arranged depends on the size and specifications of the block you need, your location, and how the order fits alongside other deliveries that week. As concrete block suppliers with our own manufacturing plant, we can usually accommodate smaller orders. Contact our team with the quantity and block type you need, and we'll confirm what's available.

Lead times for concrete block deliveries depend on order size, block type and specification, and your site location relative to our plants. Because we manufacture on-site in Avonmouth, as concrete block suppliers with direct control over stock and production, we can often turn deliveries around faster than distributors bringing material in from further afield, without waiting on a third party to release stock.

Contact our team with your order details, and we'll confirm the earliest available delivery date for your project.

Yes. While much of our work is with builders, groundworkers, and contractors, we also supply concrete blocks directly to self-builders and homeowners taking on their own projects. As concrete block manufacturers covering the wider South West and South Wales, we can help with extensions, garages, boundary walls, and other DIY builds, whatever the scale.

Blocks are available for delivery direct to your site or for collection from our Avonmouth plant, so you can choose whichever suits your project and transport arrangements.

Yes. If your project calls for more than one block size or specification, let our team know the sizes, widths, and quantities you need, and we'll confirm what can be combined within a single delivery or collection. Because we manufacture on-site, we have the flexibility to bring together different block types for the same job without requiring separate deliveries from multiple suppliers, which can simplify on-site scheduling.

We are the right people for you – let’s work together!
Contact us on 0117 958 2090 today to get a quote or to find out more.
